Crew screeding a concrete pour
Commercial

ADA Sidewalks

An accessible route has to keep its cross-slope the whole way, with no lips at joints and landings where the grade changes. Most failures are a quarter inch of cross-slope nobody checked.

Hemet, CA  ·  (951) 533-8821  ·  License 1137822

Talk to us about the job
Foundation stemwall poured
Driveway wide new build

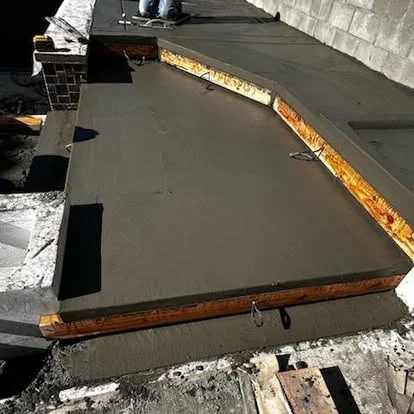

Formwork long run hillside

Driveway side approach

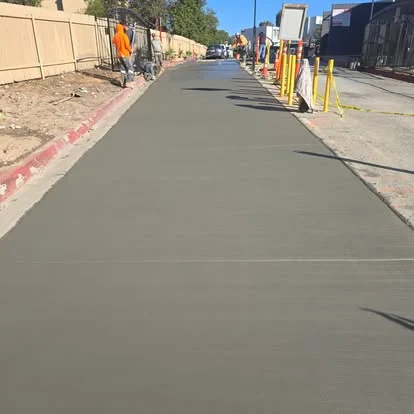

Sidewalk long pour

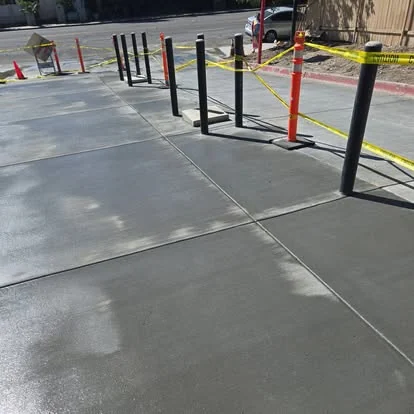

Parking bollards slab

Curb hillside run
Colored pad set entry hires
Crew curb forming
Sidewalk cones tree
Sequence

How the job runs

Step 1

Start with a site visit

No number gets quoted before somebody stands on the job. Soil, slope, access and drainage change the work more than square footage does.

Step 2

Tell you straight

We are direct about what we find. That includes telling you when a cheaper fix is the right one, and when a slab is past saving.

Step 3

Prepare what is underneath

Excavate to grade, deal with anything soft, and build compacted base. Almost every failure we get called to started here.

Step 4

Place and finish

Forms that hold their line, steel placed to the drawing, concrete consolidated, and finishing timed to the slab. Thirty two years in the trade is largely knowing when to start.

Specifics

What this job actually needs

Built to the specification

Commercial work answers to drawings: mix design, steel placement, joint layout, flatness and levelness tolerances. Those get built to and documented, because on a commercial job what was built has to be provable afterward.

Load zones

A commercial site is rarely one slab. Car areas, drive aisles, truck routes, dock aprons and equipment pads carry different loads and get different thickness and reinforcement. Pouring it all to one spec is why entrances fail first.

Working around operations

Phasing, scheduling and coordination with whoever runs the site are usually harder than the concrete. The sequence gets written down before anything is broken out so the business keeps running.

Joints and long term maintenance

On commercial flatwork the joints fail before the concrete does, and open joints let water into the base. Joint sealing is the cheapest maintenance available and the most commonly skipped.

What decides whether it lasts

Concrete is judged on the surface and it fails from underneath. The base, the steel, the joints and the cure are the whole job. A slab that was poured on bad ground will tell you so, usually in the third or fourth year.

Why fourth generation matters here

32 years on the tools means most of these problems have already been seen once. Reading a slab before quoting it is the part you cannot learn from a book, and it is the difference between a repair that holds and one that comes back.

Local conditions

What Southern California ground does to ada sidewalks

Older flatwork around here

A lot of valley concrete was poured thin, with light reinforcement, on a base that was never properly compacted. When it fails it is usually reporting on the ground rather than on the mix, and that is the difference between a repair that holds and one that comes back in a year.

Drainage on a flat lot

Valley lots are often close to level, which makes slope hard to find and easy to get wrong. Low points, cross-fall and where water actually leaves the property get worked out before the pour, because once the concrete is down the drainage is permanent.

What lasts here

A properly based, properly jointed slab with reinforcement sized to the load will outlast the house it sits beside. The variables that decide it are all underneath and all invisible once the pour is done, which is exactly why they get cut on cheap jobs.

What the ground does here

The inland valleys run on expansive clay. It takes on water and swells, then dries out and shrinks, and it does that cycle every year. A slab poured on untreated clay rides that movement until something gives, which is why base preparation and reinforcement are the design rather than an upgrade. Where a soils report exists we build to it; where there is none, what we find during excavation tells us what the ground is going to do.

Our work
Driveway finished dark

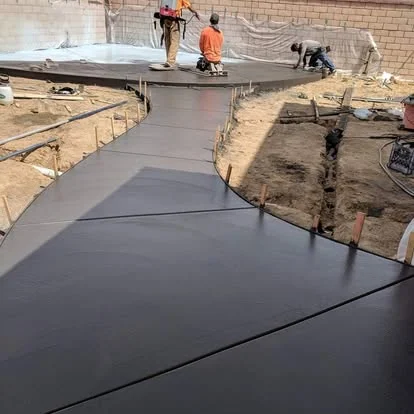

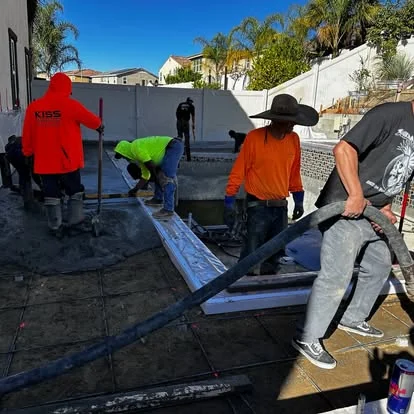

Crew screeding pour
Slab form release edge
What goes wrong

How concrete fails, and why

Settlement at the apron

The strip where a driveway meets a garage takes every vehicle and sits over backfill that was disturbed during construction. It settles more than the rest of the drive and it needs its own thickness and joint.

Heaving

A slab pushed upward is usually roots or expansive soil taking on water. Both get worse with irrigation, and neither is fixed by resurfacing the top.

Pop-outs

Small conical craters come from a particle of reactive aggregate near the surface expanding and blowing the concrete off above it. Cosmetic, and a repairable surface defect.

Dusting

A surface that chalks under a broom was finished or cured badly, or had water worked into it. Sealing helps; grinding and resurfacing fixes it.

What to expect

How a job runs

The walkthrough

Somebody comes out and looks. That visit decides the scope, and it is also when you should ask everything, because the answers get cheaper before the concrete is ordered.

What you decide

Finish, color, joint layout and edge detail are choices. We will make recommendations based on where the slab is and what it has to do.

Knowing when to start floating is the part you cannot learn from a book.
On finishing

What we decide

Thickness, base, steel and mix come off the load and the soil. Those are not preference items and we will not build them thin to win a job.

Handover

You get told how to look after it: when to seal, what not to put on it, and what normal looks like in the first year.

Related

Other commercial work

Crew troweling edge

Commercial Concrete Flatwork

Flatwork built to a plan set and an inspection.

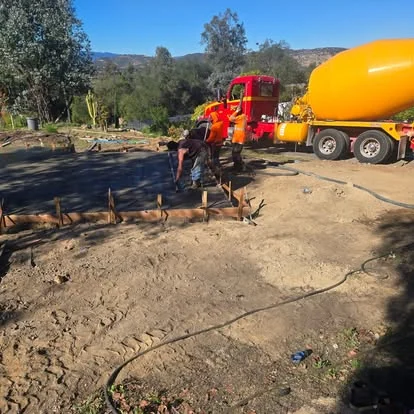

Mixer truck delivery

Commercial Concrete Slabs

Slabs sized for racking, equipment, and forklifts.

Trowel hand finish

Commercial Concrete Foundations

Footings and stem walls under a commercial structure.

Trowel edge aggregate

Commercial Sidewalks

Walks that carry public traffic and public liability.

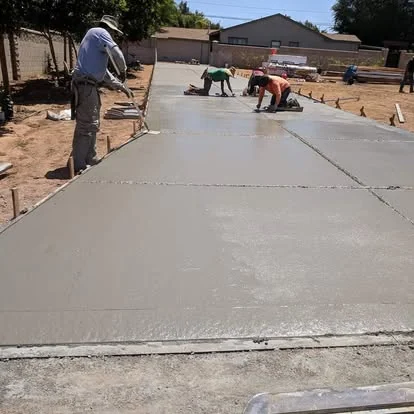

Crew finishing wide slab

Commercial Patios

Restaurant and retail patios built for daily traffic.

Driveway side return

Concrete Parking Lots

Concrete instead of asphalt, for the life of it.

Driveway side return hires

Concrete Parking Lot Repair

Failed panels replaced without closing the whole lot.

Crew portrait basement

Concrete Parking Lot Replacement

A full lot rebuilt on a schedule that keeps you open.

Straight answers

Can you phase a large lot replacement?

Yes, by area, so you never lose the whole lot at once. Drainage usually gets corrected during the rebuild, because a lot that ponds was designed wrong once already.

Do you build to our engineer’s drawings?

That is the normal way commercial work happens. Mix design, steel placement, joint layout and tolerances come off the sheet, and we keep the documentation that proves what was built.

Concrete or asphalt for a parking lot?

Concrete costs more going in and lasts decades longer, especially where trucks turn or stop. If the lot takes heavy vehicles in the same spots, concrete usually wins on the life of it.

Can you work around our operating hours?

Yes. Most commercial work gets phased so the business keeps running, with the sequence written into the schedule before anything gets broken out.

How do you handle inspections?

We schedule them into the sequence so the pour is not sitting waiting on a signature. Footings and steel get inspected before anything is covered.

Tell us what the job is
